I measure what others leave to guesswork, from the cost of big projects to the price of nature.

I co-authored How to Measure Anything in Project Management and have advised on major projects in more than 25 countries. At Aarhus University I research how to choose the right projects and make the best use of public resources, including how to measure and value nature.

Portrait of Andreas Bang Leed
Interactive

Project Risk Lab

In the Lab you can look up the reference classes published in How to Measure Anything in Project Management, which are groups of completed projects of the same type, and see how the projects in each class turned out against their estimates. You can also take the role of an investment committee that has to choose between proposals, or test whether you are right as often as your own confidence implies.

estimate median

A stylised drawing of final cost against the estimate for one type of project, in which most projects end near the estimate and a small number end far above it.

Explore the Lab
Working paper

The Price of Biodiversity

Cost-benefit analysis values the benefits and costs of a project in money and compares them. Because biodiversity has no market price, it is often counted at zero in that comparison. My research at Aarhus University estimates how the ecological quality of nearby nature is reflected in house prices. The estimates come from about 740,000 Danish home sales, each matched to the Biodiversitetskort (Biodiversity Map), a national map that scores ecological quality on a 10-metre grid.

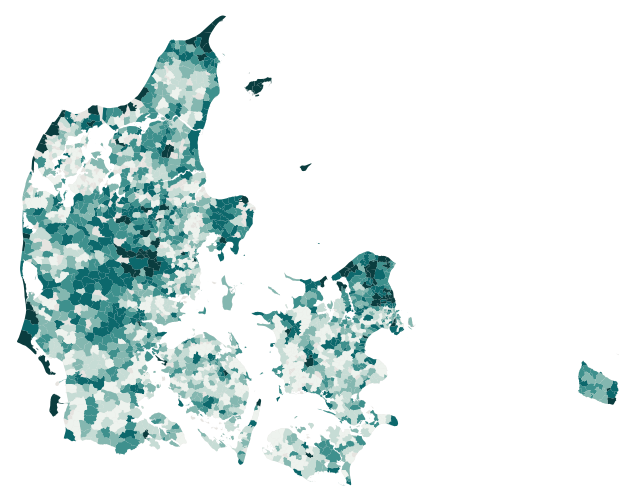

Map of ecological quality across Denmark by parish

Ecological quality across Denmark by parish.

Explore the research

Choose three projects

In this exercise you act as an investment committee that has six proposals and can fund three of them. Each proposal has an estimated benefit-cost ratio, which is its benefits divided by its costs after both have been converted to their value today, so that a ratio above 1 means that the benefits exceed the costs.

The exercise needs JavaScript to deal the six proposals, to let you fund three of them and to show the outcome of each proposal afterwards.

Six proposals, of which you can fund three

Choose the three proposals you would fund.

How this works

The six proposals are invented and all numbers are generated in your browser. Each proposal has an outcome, meaning the benefit-cost ratio that it delivers if it is built. The six outcomes are drawn from one lognormal distribution, a distribution that gives positive values only and has a longer tail on the high side. Its median is 1.25 and its sigma, the standard deviation of the logarithm of the value, is 0.11. Because all six outcomes come from the same distribution, the proposals are of similar quality and the project names serve only as labels. The exercise also shows what the proposals left out would have delivered, which a committee does not observe in practice.

Each estimate is the outcome multiplied by a random error drawn from a lognormal distribution with a mean of 1 and a sigma of 0.25. Because the error has a mean of 1, an estimate equals the outcome on average, which is the sense in which the estimates are unbiased. Each ratio is rounded to two decimals before the averages of three ratios are calculated. In a benefit-cost ratio, benefits and costs that fall in later years are converted to their value today, called the present value, before the ratio is calculated.

The figures for 10,000 rounds come from the same model, with a committee that funds the three proposals with the highest estimates in each round. They are calculated in your browser from a fixed starting number for the random draws, so that they are the same on each visit. Each new deal takes its starting number from the clock.

Source: Eliasson, J., & Fosgerau, M. (2013). Cost overruns and demand shortfalls – Deception or selection? Transportation Research Part B, 57, 105–113.

How to Measure Anything in Project Management book cover

How to Measure Anything in Project Management

Douglas W. Hubbard, Alexander Budzier & Andreas Bang Leed

The book is a practical guide to replacing guesswork with measurement in projects. It uses the outcomes of thousands of completed projects, compared with their original estimates, and the authors' survey of 209 project managers. On that basis the book presents tools for forecasting, reducing risk and making better decisions.

What people say

Andreas has a natural talent for teaching and a gift for explaining complex concepts in a way that is accessible and engaging. His lectures are always well-researched, insightful and thought-provoking.
Head of Leadership & Competence DevelopmentNCC
As a trusted advisor, Andreas simplifies advanced statistical analysis for diverse stakeholders, from risk experts to senior leadership, enabling informed and rational decisions on Britain's biggest infrastructure projects.
UK Head of Risk Management & Technical DirectorWSP
Andreas is an outstanding communicator with deep intellectual curiosity. He transforms research into practice, builds high-performing teams and delivers transformative impact, including evidence that shaped UK legislation on low-carbon energy.
Fellow, Saïd Business SchoolUniversity of Oxford
Andreas effectively uses data to develop and communicate insights. His technical skills, global experience and ability to synthesise complex information make his advice compelling, credible and thoughtful.
Director of EconomicsNew Zealand Infrastructure Commission
Andreas's work on optimism bias and reference class forecasting has been highly influential. He moves effortlessly from explaining complex analysis in simple terms to performing cutting-edge statistical work, a rare combination of skills.
Head of Economic Research & EngagementUK Department for Transport
In developing Hong Kong's AI-based Project Surveillance System, Andreas integrated vast data volumes into precise, actionable insights. Today the system monitors over 200 capital projects, optimising resources and exemplifying his analytical and creative vision.
Principal Assistant SecretaryHong Kong Development Bureau
Andreas Bang Leed presenting at a lectern with the St Hugh's College crest, Oxford, November 2026.
Presenting at the Oxford Megaproject Summit, St Hugh's College, Oxford, November 2026.

Invite me to speak

I give keynotes and workshops on major projects, on measurement and decisions, and on climate and nature.

  • The Outside View in Practice
  • How to Measure Anything in Project Management
  • The Value of a Tonne of Carbon
  • Biodiversity & Ecosystem Valuation
